Weiss Ch. 9.
Big topic, big chapter. Few observations to start.
Good news is you're getting sophisticated. Bad news is the algorithms are too. Good news: lots of what we've learned before turns up as tools and subroutines. Bad news: necessary bookkeeping complicates the examples, explanations, data structures, diagrams in tutorials, etc.
So be prepared to spend more time reading and re-reading for content, writing things down and trying examples, etc. Active learning.
There are plenty of video lectures on line for all these algorithms: I didn't find any drop-dead beautiful animations, but you might.
There are seven or so related .PPTs and .ODPs made by Prof. T. Pawlicki and linked in the schedule, which we may or may not go thru in class: you definitely should go thru them if possible and mentally reverse-engineer the coherent lecture that used them.
Weiss Ch. 9. The algorithms in this chapter are hard enough to raise issues of complexity that are broader in scope than Big-Oh counting. Like: what can and can't be computed, and what looks like it's going to be exponentially hard even if we can't prove it.
Also the idea of a "non-deterministic" program -- it's got precognition (it doesn't search, it always guesses the right choice) or it's got infinite parallelism (it explores all search choices in parallel).
Last, a cool fact: there's an important class of "NP-Complete" hard problems (probably exponential), and totally equivalent in the sense that if we could solve any one of them quickly we could solve them all quickly.
Problem reduction e.g. Alternately you and I pick numbers from 1--9, (no repeats). First one who can sum 3 of his numbers to 15 wins. Reduces to what?
Graphs are everywhere: (TP's ppt). VLSI, crystal structure, internet connectivity, facebook friend maps, street maps, industrial processes, classroom scheduling...
Graph Definitions and Motivations: lots, including G = (V,E) (vertices (nodes), edges (arcs)). Edges directed (digraphs) or undirected; edges weighted with costs or not. Path, length of path, simple paths (vertices distinct except 1st can = last). Cycles and acyclic and DAGs. (Undirected) connected graphs, directed strongly connected graphs: complete graph has edge between every vertex pair.
A "linear time" graph algorithm is O(|V|+|E|) = O(max(|V|,|E|)), which is also the space required to represent it in an adjacency list, and which presumes the graph is sparse, not dense. A dense graph has O(|V|2) edges, which is the space required to represent it as an adjacency array.
Representations: Adjacency lists and arrays:
List: Fig. 9.2 (indices of digraph adjacencies in a list at the index of each node). Really, what I call an Augmented graph representation -- in Java,
Array: for N nodes, NxN array A with 1 (or cost)
at A(i,j) if node i points to node j. Neat way to prove some graph
theory results but is inefficient and expensive (Θ(N2))
unless graph is dense
(i.e. |E| ≅ |V|2), and most 'real' graphs aren't.
Several key algorithms that are rather closely related and which make sense to study sequentially.
W. 9.4- 9.7
More pretty problems with practical, prosaic, profit-affecting power.
Finally, 9.7 is NP Completeness.
So we're going to have to make some choices here.
A Topological sort is an ordering of vertices in DAG such that if there is a path from v to w in G, w appears after v in the order. Imagine course prerequisites. Not possible if graph has cycle. And not unique.
Idea: find vertex with no incoming edges (indegree 0). print it out, remove it and its edges. Repeat until done. Scanning the adjacency array repeatedly gives O(|V|2) time.
Faster is to keep the un-printed vertices of indegree 0 in a special spot so we don't have to hunt for them. Like a stack or queue. With adjacency lists, the main action of the algorithm is executed at most once per edge (code in Fig. 9.7). Need to get started by computing indegrees of all the nodes, which like the main algorithms is an O(|V|+|E|) calculation.
Important (p. 366). Driving times, comms costs, etc. Generally, weighted graph (with costs on edges). Can solve unweighted SP on such a graph too.
Single-source Shortest Path Problem: given weighted G = (V,E) and distinguished vertex v, find the shortest weighted path from v to every other vertex in G.
If graph has a cycle with negative cost, shortest path isn't defined.
Upcoming: unweighted SP in O(|V|+|E|), then weighted no neg. edges in O(|E|log|V|). Simple but costly solution to negative edges, O(|E||V|). Acyclic graphs can be done in linear time.
This is good place to get familiar with the bookkeeping that Weiss uses for these SP algorithms. It's a simple 4-column table that collects partial and final results, computed both from it and from a simple graph representation.
(vx, status, s-vx dist, prev vx.) v known dv pv v1 T 0 0 v2 T 3 v1 v3 F inf 0 ...
Ch. 9.3 uses sequences of these tables to illustrate the computation.
BUT! The algorithms that use the tables are O(|V|2), and therefore considered bad. The problem is having to look thru all vertices to select one to work on: we'd like smarter "vertex selection", which we can get by using an ancillary data-structure like a queue or a priority queue. So:
(graph rep +) table sequence: good for understanding computation.
Augmented graph rep: good in more efficient data structures (queues,
etc.) with better Big-Oh performance.
Reader's Guide: Figs 9.10-9.14 show SP calculation with an augmented graph (presumably array-list) represention. THEN the table is introduced and you get Fig. 9.16 for the algorithm code and Fig. 9.19 showing what happens to the table. THEN you're told "raw table means quadratic performance, don't do it", THEN you're shown the queue program in 9.18 which would produce the results of Figs. 9.10-9.14. (!!). This pattern is going to continue, so be ready.
As for top.sort, first effort is O(|V|2), and second makes clever use of a queue both to represent and keep separate two "boxes" of vertices of interest to be investigated next. As in top sort, similar algorithm and analysis: O(|V|+|E|), or linear.
Weiss asks in exercises: using a stack instead of a queue, can a different ordering arise? Why might one choice give a "better" answer?
Famous, elegant, and greedy. Make decisions using "nearby", locally-available information without searching or looking ahead. E.g. Hillclimbing, or gradient ascent, which works for some functions, not for others. If it works, no going back, no tiresome searching, efficient.
Designate vertex s. Just like unweighted SP, keep for each vertex its known-status, tentative distance to s, the last vertex added to path that caused change in the distance (note this will be the vertex preceding it in the (tentative and final) shortest path. The distance is the shortest path from s to v using only known vertices. An unknown vertex may offer a shorter path.
D's A. picks a vertex v with the smallest dv amongst all the unknown vertices, changes its status to known and updates its shortest path distance to s. That means that the tentative distances of its successors may have to be updated.
That is, for a vertex w adjacent to v, change its dw to dv + cost(v,w) if that's an improvement.

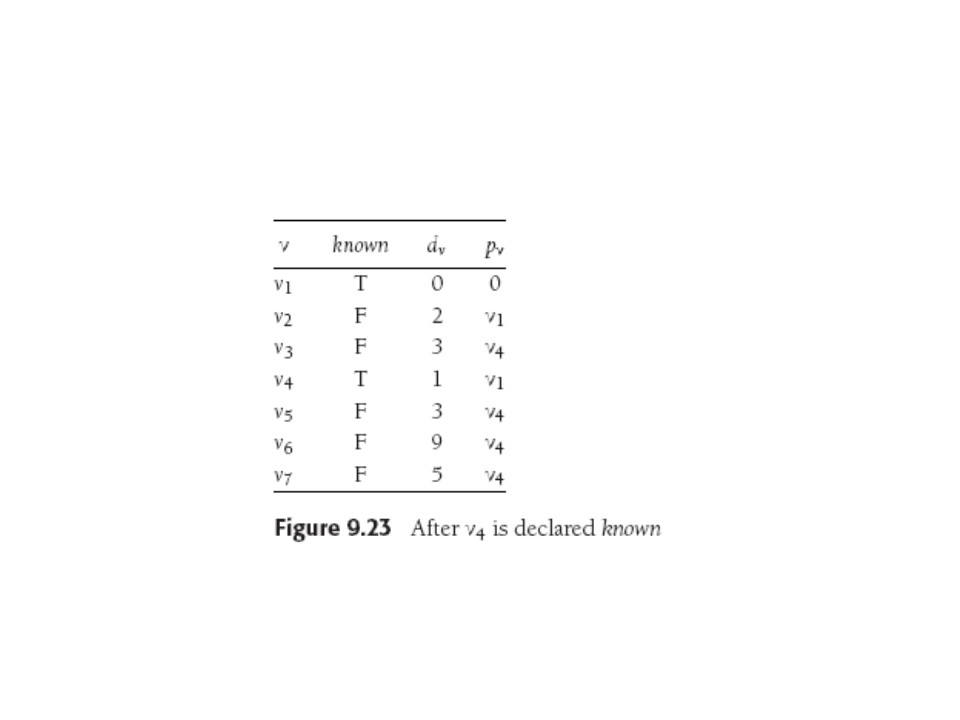

You wish. Here's our graph: our s is v1.
Thinking of an evolving table with rows for
v status dv pv states.
The first v1 is
declared known, leaving v4 as the unknown-status vertex of minimum dv,
so it is "known" next, and then we see:
Follow along on p. 375. Or one can pack everything into a graph movie using the augmented representation in which each vertex has status, distance-from-s, and previous-vertex information. Colours would be better (as in TP's PPTs). Here vertex names and edge costs are obvious. The small numbers by vertices are their tentative distances (dv's), the *'s are 'known' status.
Analysis: note edges with negative costs can cause wrong answers for the greedy algorithm, so we disallow them for now. Once again, sequential scanning of the adjacency list to find the minimum distance takes O(|V|) time for each vertex we consider, thus O(|V|2) time for the whole algorithm. Since there is at most one distance update per edge, we have O(|E| + |V|2). This is good, in fact linear, for a dense graph, which has O(|V|2) edges.
For the more usual sparse graphs, (|E| = Θ(|V|)), the same old objections, so we need a "box" to put vertices so we can.... pull out the smallest. So....?
Right, priority queue, and there are two different ways to use it:
1.
selection of a vertex is clearly deleteMin(), and updating the
tentative distances can be done with a decreaseKey() operation (Ch
6.3.4 -- change the key and percolate up).
This gives O(|E|log|V|+ |V|log|V|)) = O(|E|log|V|).
The location in the
p-queue
of each successor is found from the adjacency list of a vertex, and
their distance di must be maintained and updated whenever
di
changes. Weiss says that a binary heap is not a good choice here, but
a pairing heap (way ahead in Ch. 12) is better.
2. The second method is perhaps a bit uglier, leaving the queue full of old values that don't matter but do take up space. --- p. 378.
Weiss 9.3.3: Dijkstra fails: Despite negative costs being extremely rare in real problems, we academics of course and therefore consider negative costs a challenge. The problem is an unknown negative cost path can give shorter path to the "known" vertex. Fairly simple fix, but result is O(|V||E|). Neg. cost cycles can be detected.
Weiss 9.3.4

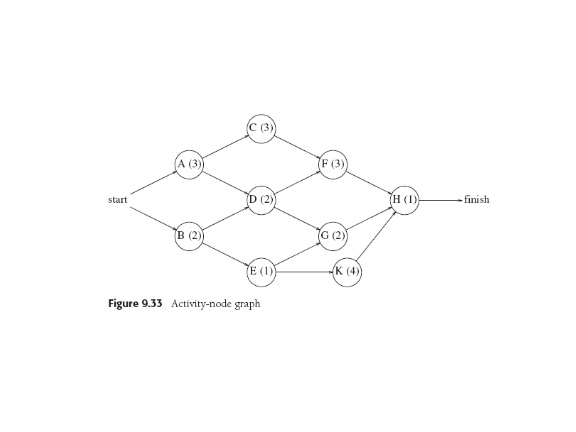

With a DAG, the natural vertex selection goes in topologically-sorted order (Aha!). In fact, all necessary updates can be done as the sort goes on, so it's a one-pass process. Lots of real situations handled by DAGs; say you have activities (manufacturing, processing) that may depend on the completion of other activities.
Activity-node graph has dependence (arcs); vertex has cost (time) of the activity.
Computation uses an "event-node graph" easily made from the activity-node graph.
Relevant questions: What's earliest completion time? Given that, managers might want to know what activities can be delayed, and by how long, etc.

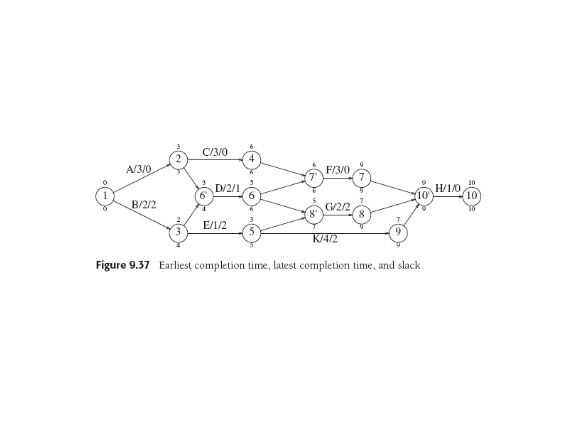

The earliest completion time is the longest path from first event to last event. Longest paths make sense here becuse our graphs are acyclic. Weiss gives Dijkstra-like formulae for EC and for LC, the latest time an event can finish without affecting final completion time. The slack time of an edge is the amount one can delay the corresponding activity without delaying overall completion time.
What it says. Could run Dijkstra's SSSP |V| times (best for sparse graphs). For dense graphs, there's a special version of the same approach that has tight loops and could beat D's Alg. Both are O(|V|3).
